As mentioned in the previous post, we’re already three weeks behind because of the delay in burying the overhead low voltage power cables that was connected to the demolished building and the house next door.
On that basis, we’re going into week seven of the construction programme next week. The entire programme plan spans a period of fifty five weeks. Given the delay, we’re now looking at middle of August 2020 for completion.
I’ll start to label subsequent posts according to the week in the programme and what the activities are. The piling work was completed yesterday.

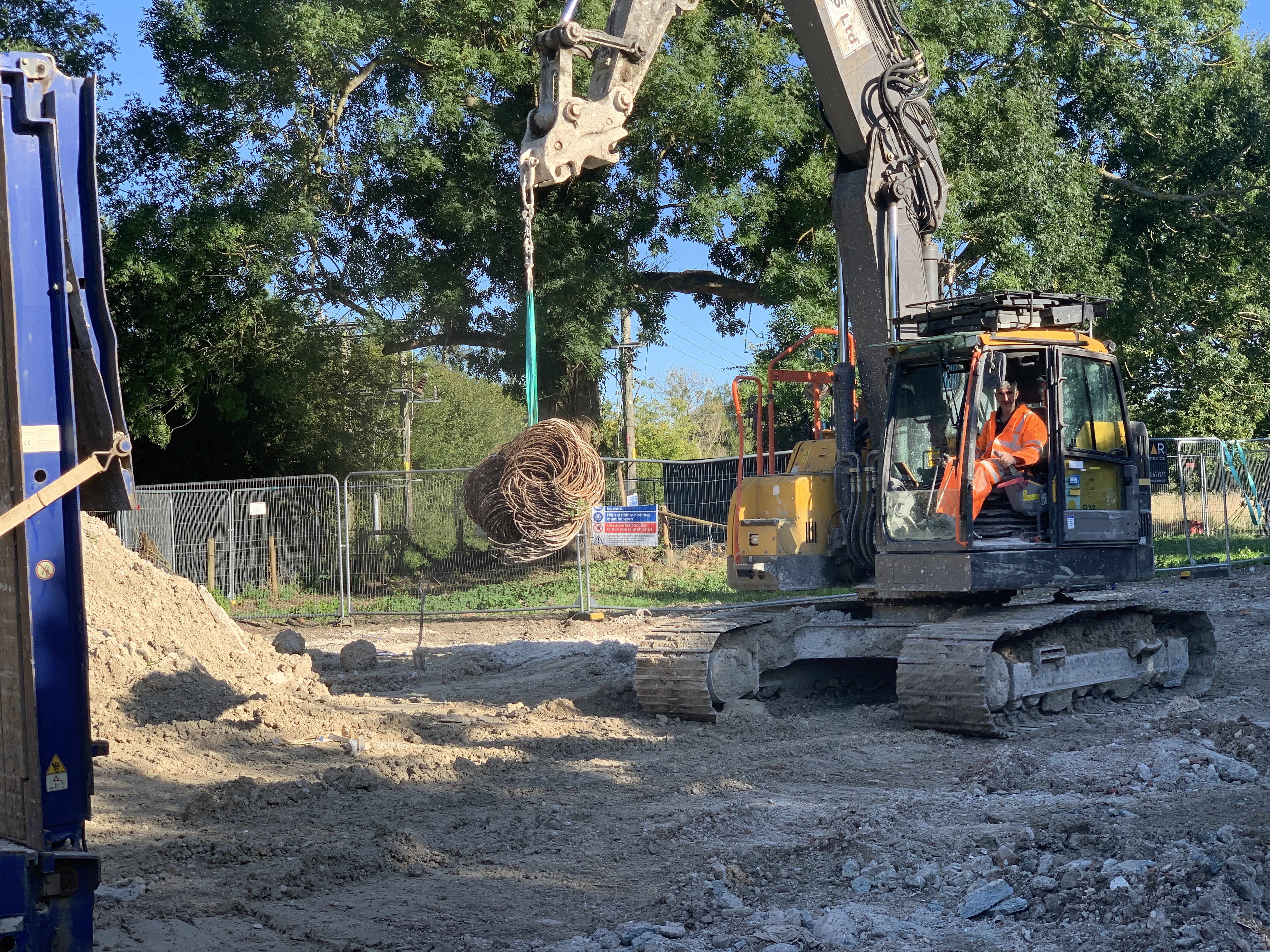

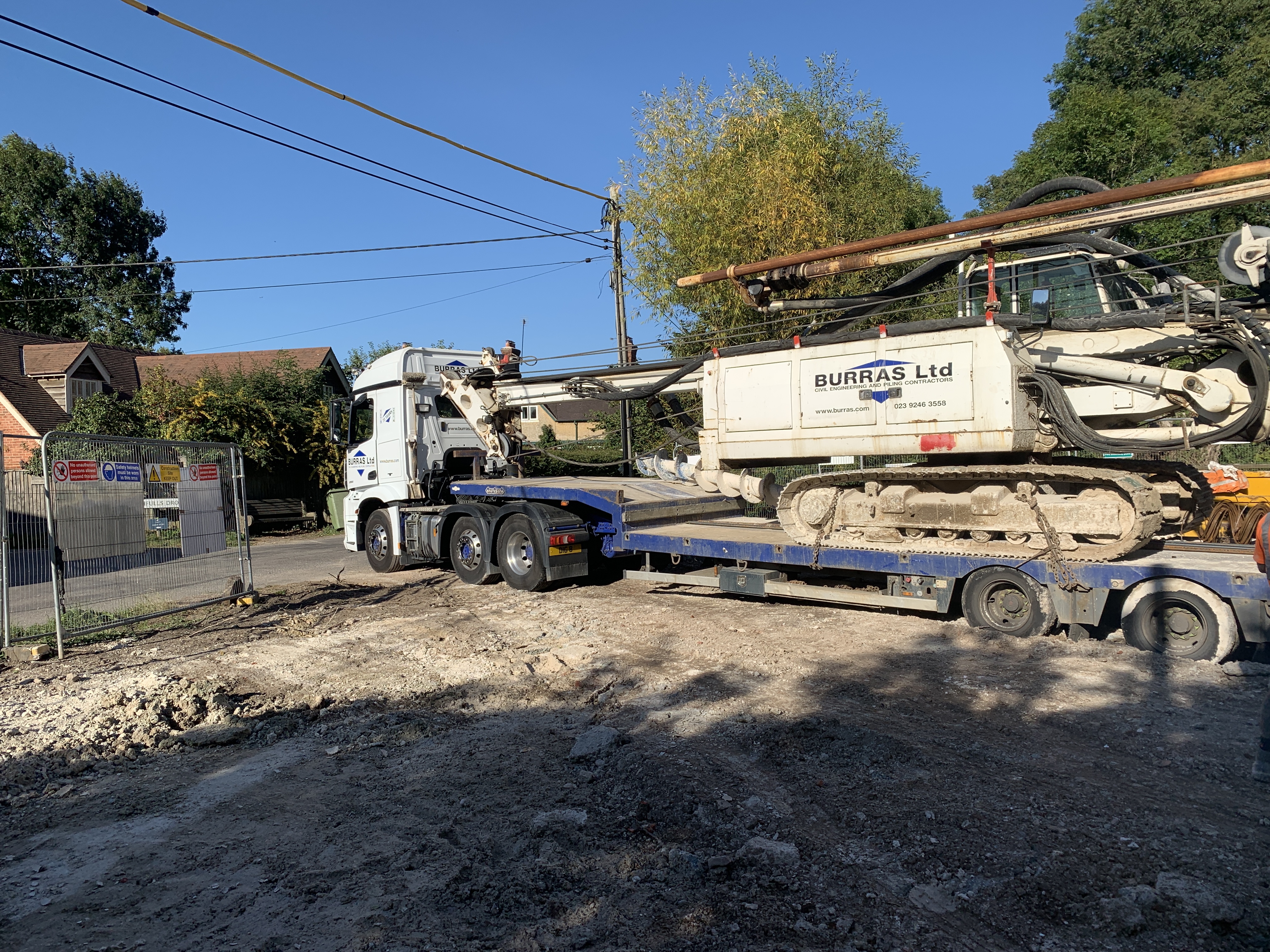

Here are a few pictures from site yesterday. The piling sub contractors were moving their equipment offsite yesterday.
